I recently asked the question about P6: “How does one show a milestone’s date to reflect the earliest start date of the group predecessors’ activities rather than total float driving from the group predecessors’ activities.”
After I little bit of thought I devised the following solution.
Download a pdf of this article by clicking on this link>>>

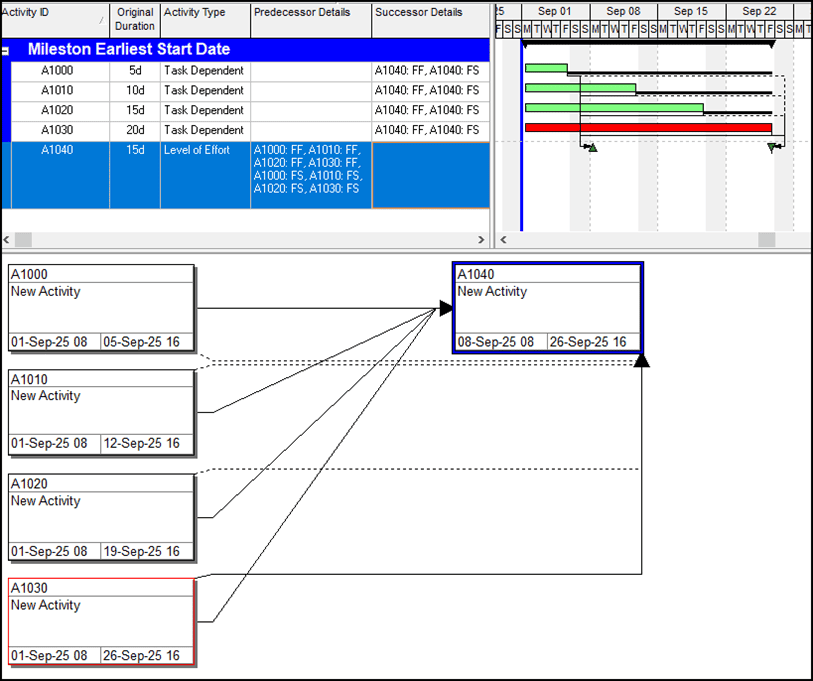

To show the earliest Start Date and Latest Finish date of multiple predecessors for a Milestone you need to make the Milestone Task a LOE and hook up to all the predecessor tasks with both a FS and a FF link as per the picture below:

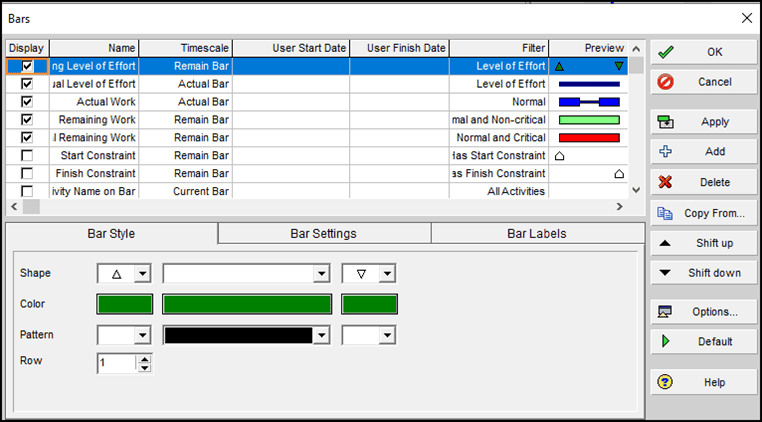

If you want to show other LOE activities as a LOE then you will need to create an Activity Code for normal LOE activities and Milestone LOE activities and a bar style for both and apply the filter to the two LOE bar styles in the Bars form.
Eastwood Harris Resources
Accelerate your understanding of scheduling software to advance your scheduling career and be able to prepare better schedules with Eastwood Harris books, training courses and online videos on the following software packages:
- Microsoft Project,
- Oracle Primavera P6 and
- Elecosoft (Asta) Powerproject
Online videos available through Udemy by following these links:
Please follow these links:
- Eastwood Harris books and training materials are available here https://www.eh.com.au
- Eastwood Harris inhouse, one-to-one and public training courses are offered through Primaskills Pty Ltd, more details here>>>>.
Paul E Harris
Director Eastwood Harris Pty Ltd
16 May 2023
www.eh.com.au
